From time to time, there are construction zones along the RuhrtalRadweg. We’ve compiled a list of all the construction projects we’re aware of here so you can plan ahead. Detours are always set up and clearly marked on-site. The detours are not included in the GPX track to avoid confusion caused by too many different GPX tracks circulating.
In the event of flooding along the Ruhr River, you’ll find the corresponding flood detours here. Please note that the ruhrtalFähre Hardenstein may suspend operations at short notice even during the off-season if water levels are too high. You can find the daily updated ferry schedules here: https://www.wabembh.de/
In addition to construction sites directly along the RuhrtalRadweg, there may also be closures or service disruptions when traveling by train. You can find all the information we have on this topic HERE.
Before you start your trip, please always check the following link for the latest updates to see if there are any substitute schedules, delays, or changed connections:
www.zuginfo.nrw
The following construction sites and route plans for 2025 have already been announced. This list is updated on an ongoing basis:
Route Segment | Period: 2025 | Measure | Impact |
| Bestwig–Brilon-Wald Forest | June 22 – September 21 | Tunnel work | No train service, Travel to Winterberg not affected, Mon–Fri: hourly service to Winterberg |

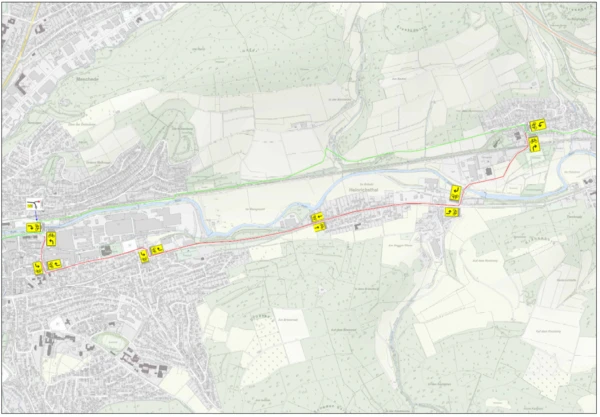

| Wickede–Meschede | May 8–May 19 | Switch work | No train service Travel to Winterberg affected |
| Schwerte – Wickede & Fröndenberg – Menden | May 21–26 & May 30–June 3 & June 11–16 | Switch work | No train service Travel to Winterberg affected |
| Warburg – Scherfede | Aug. 20–27 | Switch work | No train service Travel to Winterberg not affected |
| Arnsberg – Bestwig | September 29 – October 4 | Switch work | No train service Travel to Winterberg affected |
| Messinghausen – Warburg | Oct. 22 – Nov. 1 | Switch work | No train service Travel to Winterberg not affected |
Brilon-Wald – Willingen | May 11 – May 26 | Switch work | No train service Travel to Winterberg is not affected |
Starting in spring 2026, the RuhrtalRadweg will be expanded in several phases. Progress updates, road closures, and travel information will be regularly updated on the website.

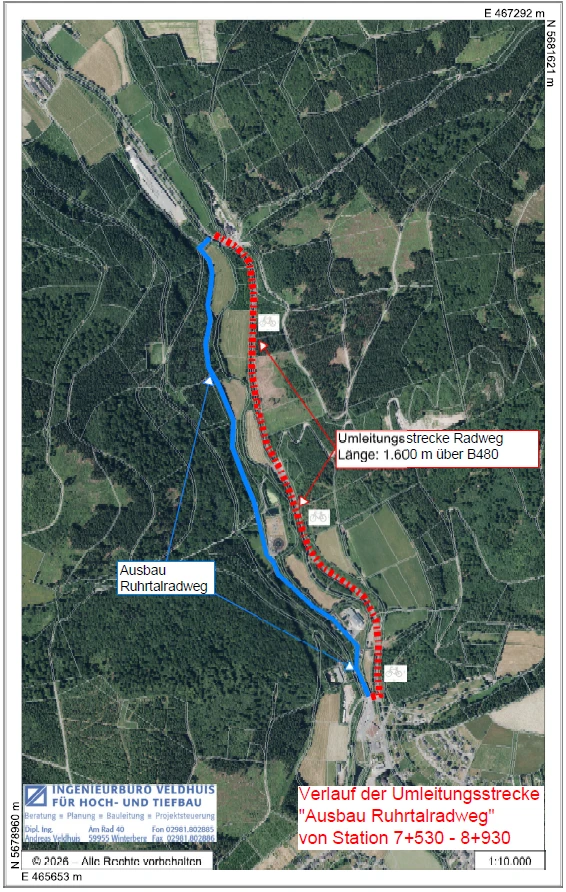

1) Construction between Niedersfeld-“Im Stein” (Station 7+530) and Haus Wildenstein (Station 8+930) began on April 7, 2026.
A detour via the B480 has been set up and is signposted during the construction work (see map excerpt).
Construction is expected to last until the end of 2026.

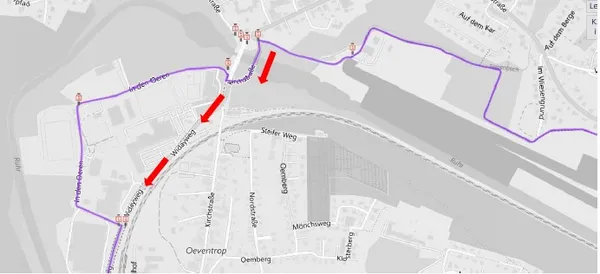

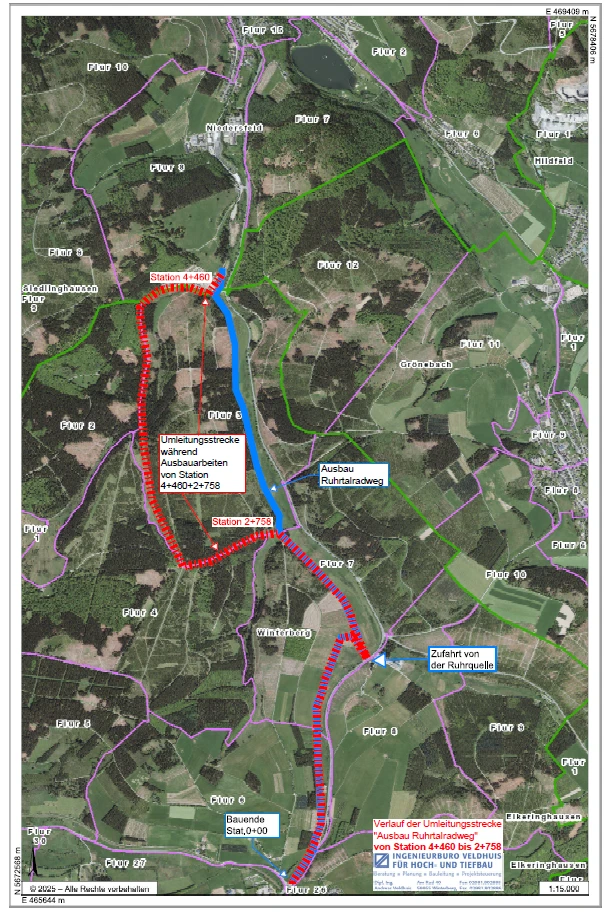

2) Starting May 4, 26, construction will take place between Voßmecke (Station 4+460) and the turntable access road (Station 2+758).
A detour has been set up and is shown in the image below.
Estimated construction period until the end of 2026.

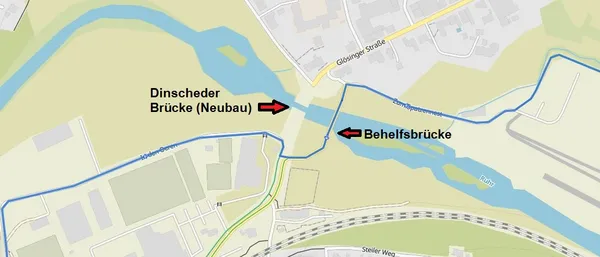

3) Starting in spring 2027, construction will begin between the turntable access road (Station 2+758) and the Winterberg roundabout.
During the expansion work, traffic will be rerouted via the existing bike path and detour. A sketch of the detour is shown below.
Please note: During these construction activities, access from the RTRW toward “Ruhrquelle” will not be possible.
Construction is expected to last until the end of 2027.

Due to construction work, the RuhrtalRadweg between Nuttlar and Ostwig is closed in the area of the Nuttlar Halden. The closure begins on Monday, June 29, and is expected to last about two months. During this time, cyclists will be rerouted via Schildstraße in Ostwig. Alternatively, cyclists can use the bike path along the L743 through Nuttlar. The municipality of Bestwig asks all road users for their understanding.

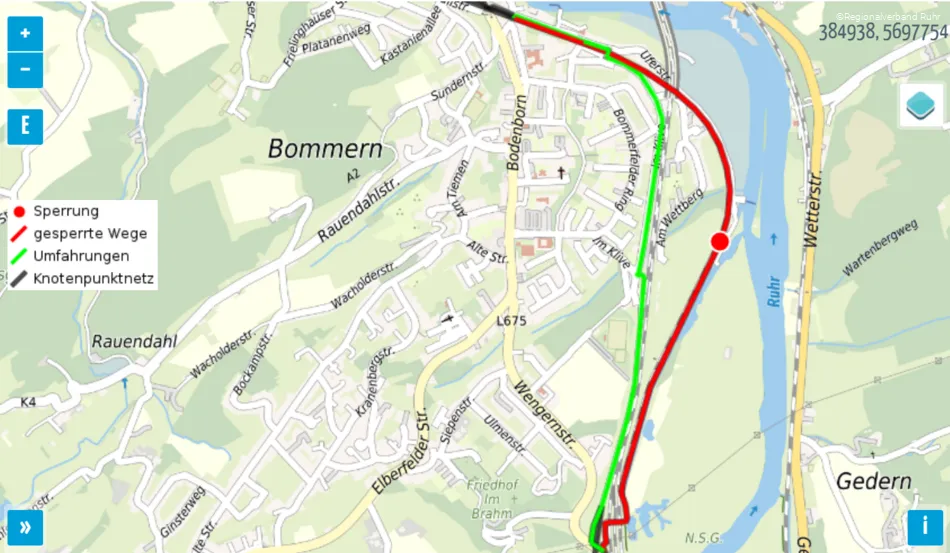

The RuhrtalRadweg is closed starting at the bridge on Kurt-Schuhmacher Street, just before City Hall. The detour runs along Kurt-Schuhmacher Street and Bahnhofstraße, rejoining the RuhrtalRadweg in front of City Hall Square.
The closure will last until October 2026. The reason is the reconstruction of Rathausplatz. The bike path will follow a new route in this area and will be integrated into the town hall’s surroundings, featuring a pleasant atmosphere and seating areas.

Construction of the new pedestrian and bicycle bridge in Wickede (Ruhr) has begun. The entire construction phase will last until 2027. The long construction period will be offset by a new, wide bridge that will make cycling there a breeze.
Please be mindful of construction traffic and do not ride too fast in the area around the construction site.

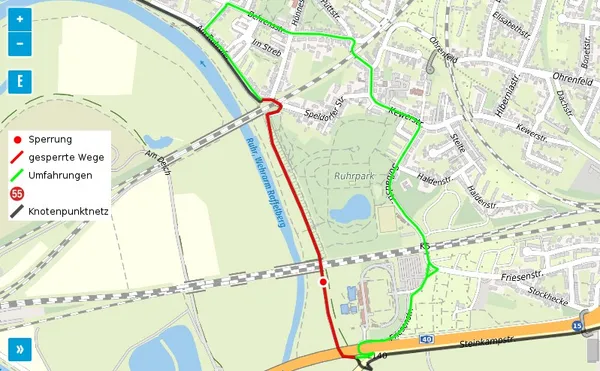

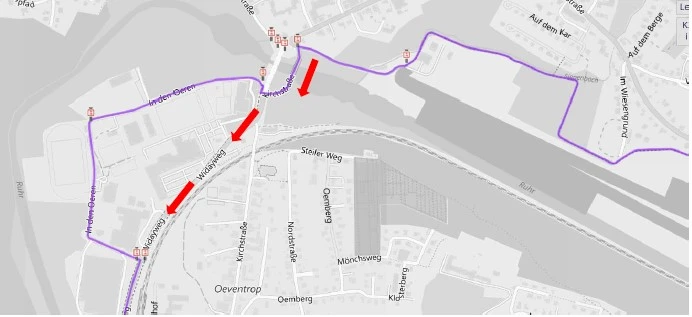

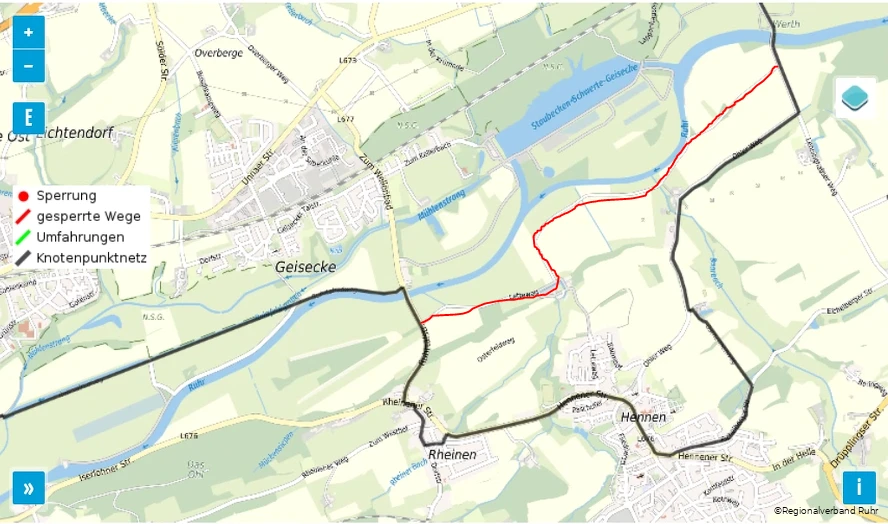

In Iserlohn, there may be short-term closures on the main section of the RuhrtalRadweg. An alternative route is signposted on site and marked on the map below for your reference.

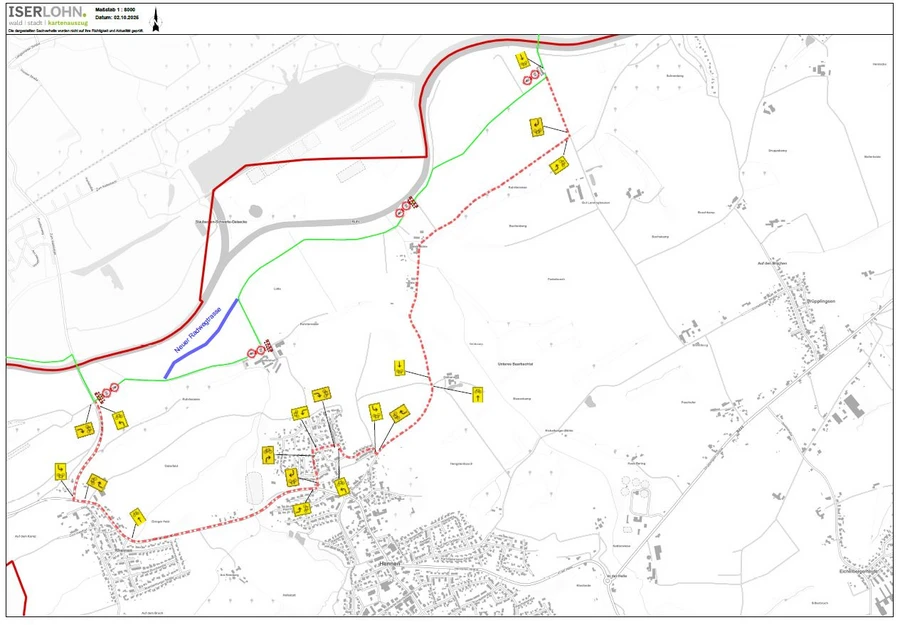

In the long term, the RuhrtalRadweg will be relocated closer to the Ruhr River here; planning is already underway. The city of Iserlohn will begin construction of the new alternative section along the Ruhr on April 20, 2025, and, according to the schedule, it is expected to open during the 2026 season. The closure will be in effect from April 27 until, tentatively, June 19, 2026.
Until then, we ask all cyclists to ride slowly and cautiously on the affected section of the trail and to be considerate of the animals and residents in the area, so that the private operator can keep the trail open on their property until the new section opens.
Thank you very much for your support!
An event will take place over the weekend of July 10–12, 2026, in the area of the Gibraltar Coal Mine on Kemnader See. This will result in a restriction on a section approximately 150–200 meters long. Please pay attention to the on-site information, walk your bike, and get ready to enjoy the live music along this section of the route.

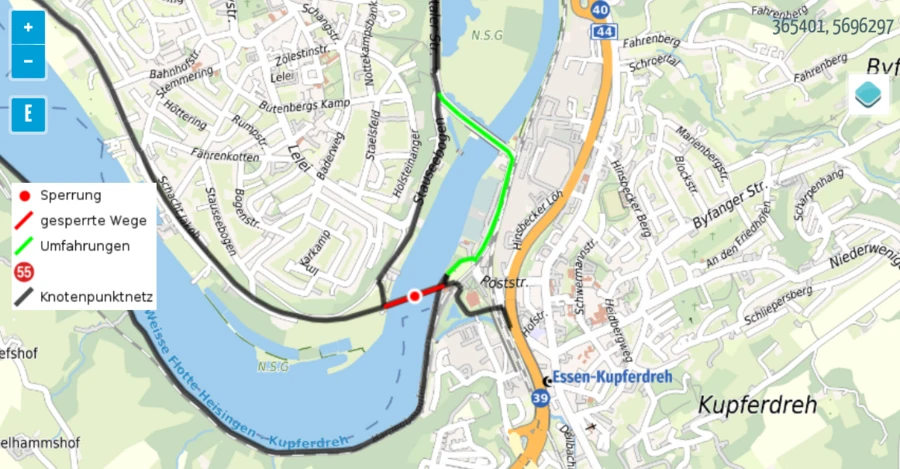

Closure period: January 22, 2026 – unknown

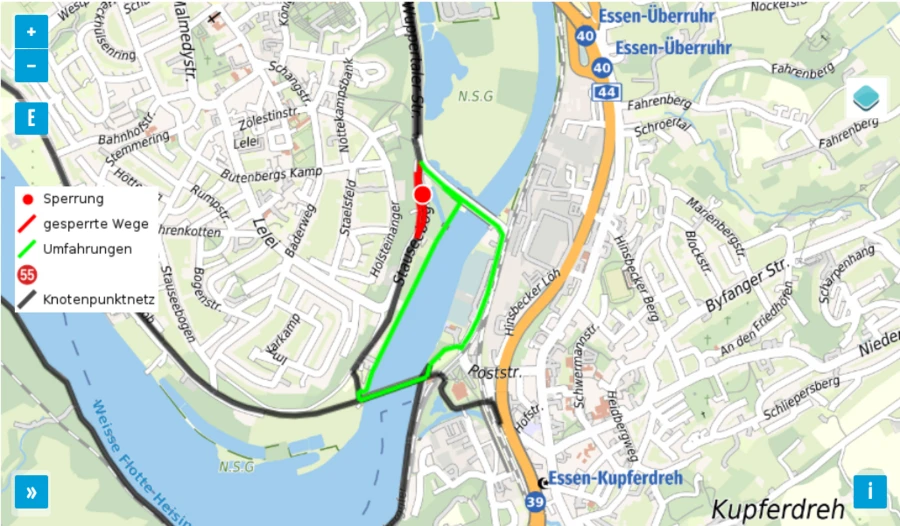

The wooden structure of the former railroad bridge must be repaired, PROBABLY by summer 2026. A smooth detour for bike routes between KP51 (end of Grugatrasse) and Kupferdreh (KP54)—including the Ruhrtal Bike Path—is signposted via the Kampmann Bridge, located a short distance to the north. At the very next junction downstream, just before Kupferdreh, you can turn right down to the riverbank to rejoin the routes.
Due to construction work on the Karl-Lehr Bridge in Duisburg-Kasslerfeld and at the Ruhr weir, there will be a closure lasting several years at the end of the RuhrtalRadweg—both at the weir itself and under the bridge on Ruhrorter Straße. Unfortunately, these large-scale renovations are beyond our control, and a bike path must, regrettably, take a back seat to such projects. Since none of the possible detours were ideal or appealing—and they do not meet the standards of a 4-star quality bike path—the RuhrtalRadweg will be rerouted for the duration of the construction, which is expected to last several years.

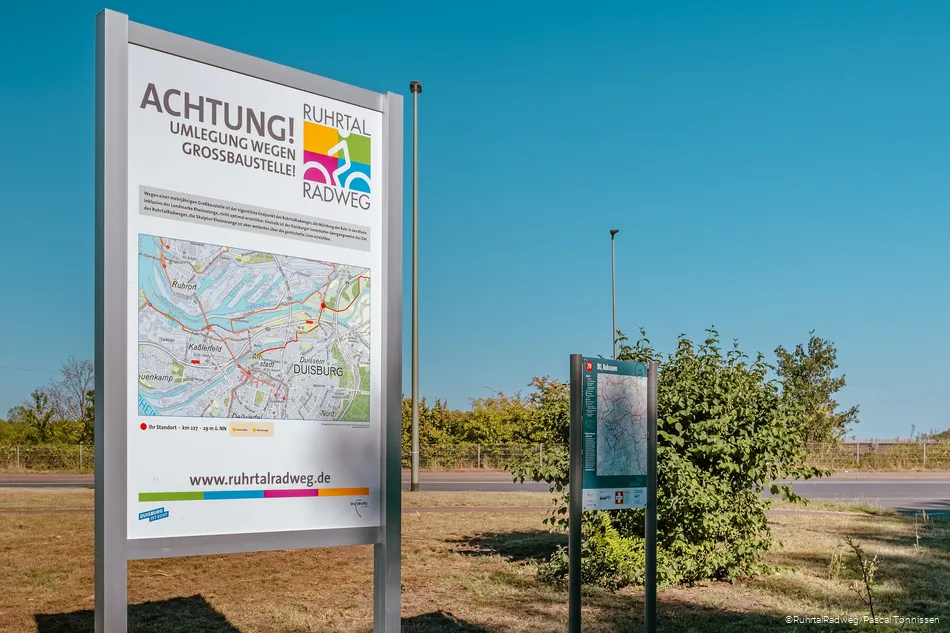

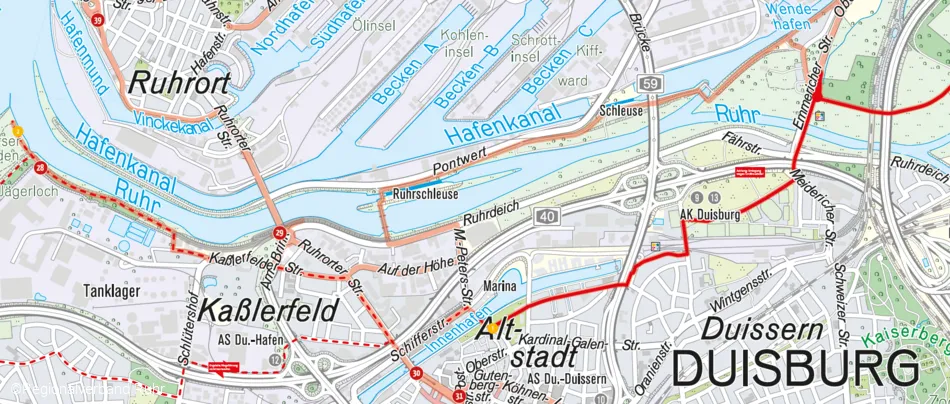

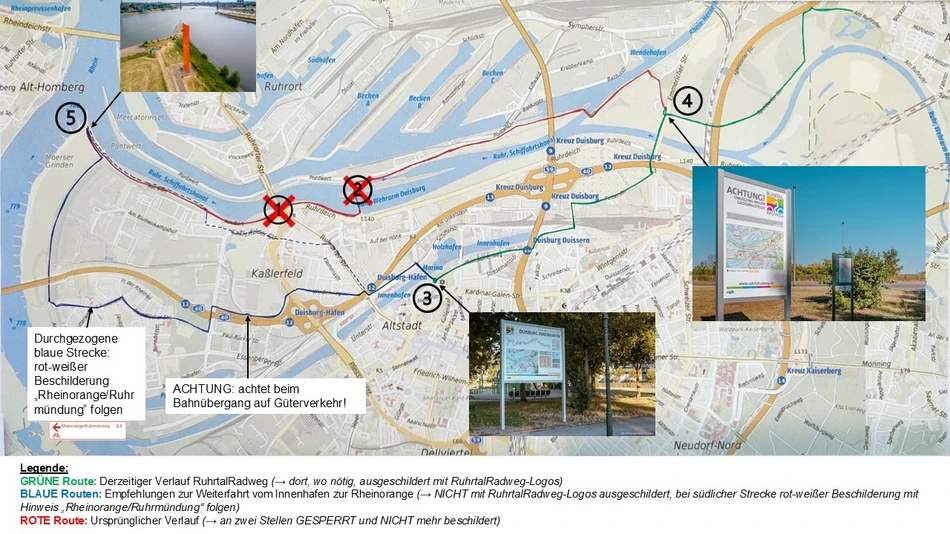

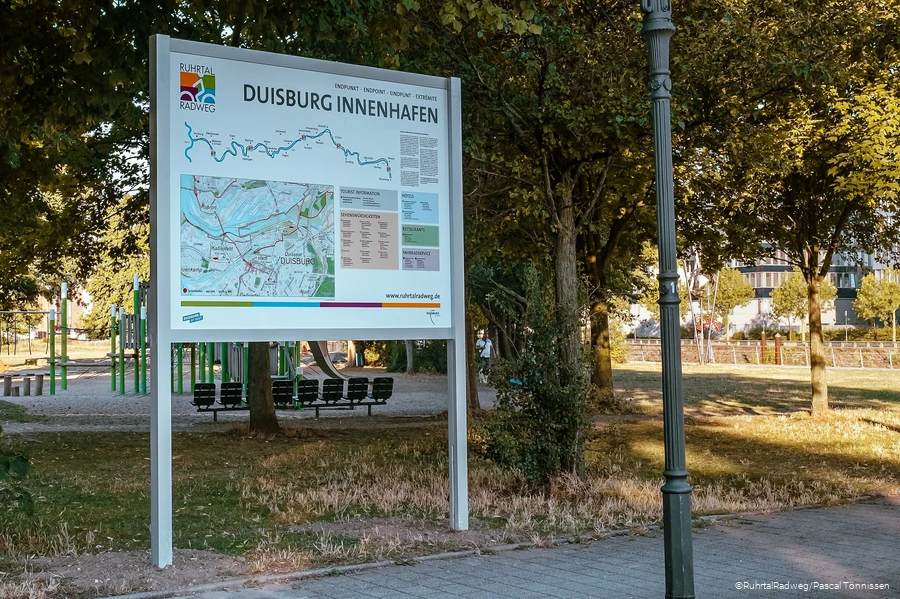

The new route now branches off at Emmericher Straße and leads through Duisburg-Duissern directly to the Buckelbrücke in Duisburg’s inner harbor, where you can comfortably round off your tour at one of the many restaurants and cafes. The route has been specially re-signposted and, in some sections, even repaved. In addition, tourist information boards with overview maps have been installed, and our GPX tracks have been updated. With this new, temporary destination, you’ll enjoy a touristically appealing conclusion to your tour. For anyone who’d like to continue cycling to the Rheinorange, there are also suggested routes from the Inner Harbor to the Ruhr estuary (these are also shown on the two signs on-site):
